NaoDec Build — Step 2: NaoDec Structure Set-Up

Revision: 1.1 Date: 2026-07-14 Status: 2.1 (panel build) is outlined pending materials; 2.2 (panel installation) is now specified per the author's decisions — hinged pairs, erection order, and the all-edges-hinged rule. Residual unknowns (door mechanism, hinge spec, bracing) are in Open Items.

Rev 1.1 — §2.2 Panel Installation filled in per decisions 6+7 and 9 in NaoDec_Build_Pending_Decisions.html: every lettered edge carries 2 hinges (ground edges none), panels pre-build into 5 hinged pairs + the door, erection runs lower section → upper section → ceiling pair. Face references aligned to the marking-guide renumbering (Face N = fN).

Rev 1.0 — Initial outline (2.1 panel build; 2.2 was undefined).

Purpose

Step 2 builds and erects the NaoDec frame itself on top of the Step 1 platform: the 11 built pentagon panels of a regular dodecahedron, joined edge-to-edge by hinges.

Quick Reference

Fact Value
Shape Regular dodecahedron — 20 vertices, 30 edges, 12 pentagon faces
Faces built 11 of 12 — f12 (bottom) intentionally unbuilt as the entry opening
Panel construction Wooden frame + stretched fabric
Panel grouping 5 hinged pairs + 1 single panel (the door f11)
Pair hinge joints M (f7-f8) · O (f9-f10) · R (f2-f6) · T (f3-f4) · U (f1-f5)
Joint fastening 2 hinges per lettered edge — all 25 joints (50 hinges); the 5 ground edges get none
Door face f11
Top / ceiling face f1
Dihedral angle ≈ 116.57° between adjacent faces (regular dodecahedron)
Joint marking Matching letters join (A–Z, no W) — 25 lettered joints, per the marking guides
Edges resting on the platform 5 unlettered edges, on faces f7f11

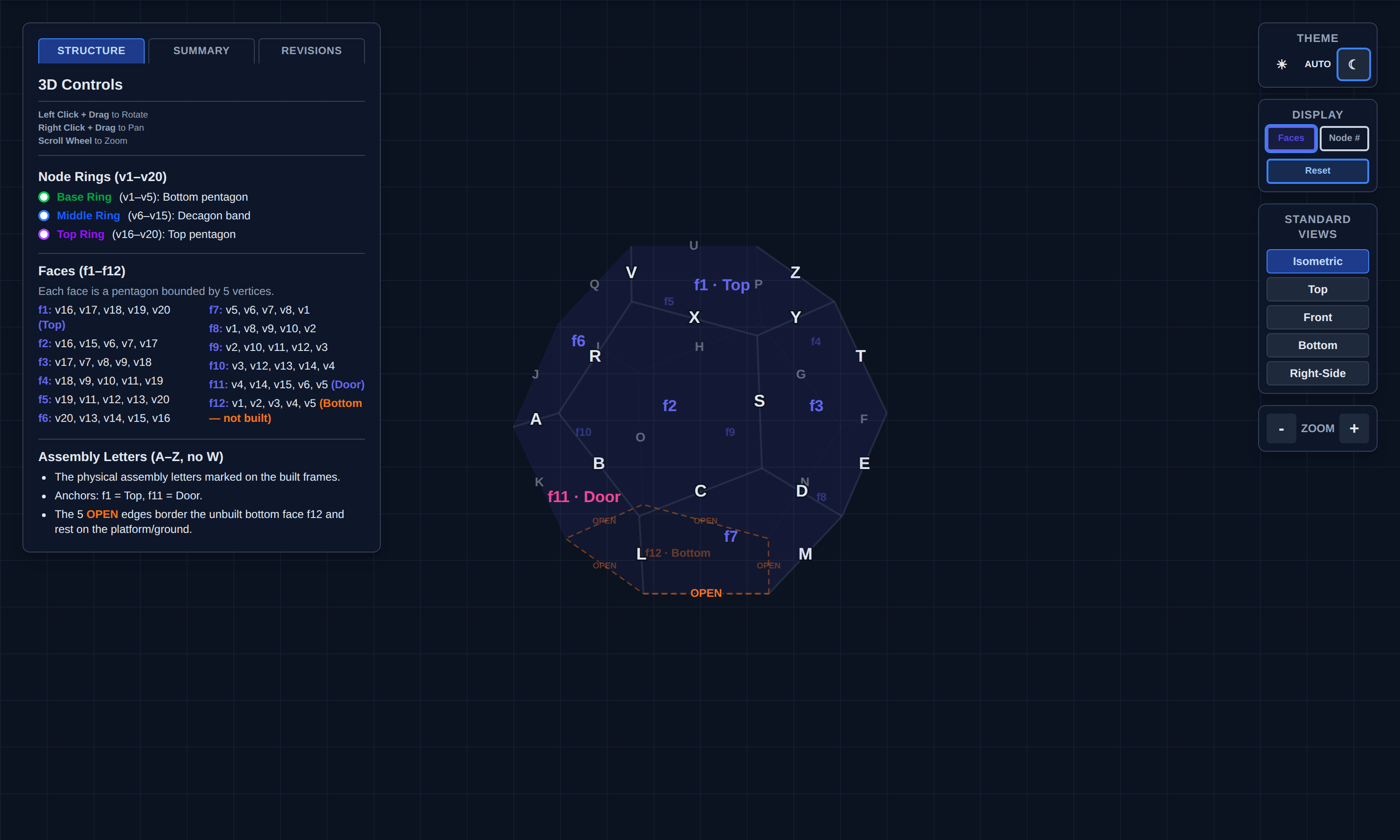

Assembly letters and faces — isometric view Assembly letters on the 30 edges, f1 · Top, f11 · Door, and the 5 dashed OPEN base edges. Snapshot of NaoDec_3D_Structure_Framework_Rev1.0.html (isometric, dark theme).

2.1 Pentagon Panel

Purpose: build the 11 wooden-frame + stretched-fabric pentagon panels.

2.1.1 How to Build the Panel?

Inputs needed (not yet specified):

Whatever the build method, every panel needs its assembly letters transferred onto the frame at each edge, per NaoDec_Face_Edge_Marking_Rev1.0.html (or the interactive variant), and its hinge halves fitted at 2 positions per lettered edge (see 2.2.1) — ideally on the bench, not on the ladder.

2.1.1.1 Side and Ceiling

The build method splits into Side and Ceiling variants:

(TBD — the actual build steps, materials, and what specifically differs between Side and Ceiling panels are pending the author's input.)

2.2 Panel Installation

Reference geometry: NaoDec_3D_Structure_Framework_Rev1.0.html (or the snapshots offline).

2.2.1 Hinged pairs — how panels attach

Every lettered edge gets 2 hinges; matching letters join. Only the 5 ground-resting edges have no hinges. The hinges are the panel-to-panel fastener — no separate bolts/clamps are specified. A hinge allows the pair to fold during handling; once the last panel closes the solid, the geometry itself locks every dihedral at ≈ 116.57° and the assembly becomes rigid.

Pre-build on the bench: 5 hinged pairs + 1 single panel (the door):

Pair Faces Hinge joint Hinge edge (vertices) Section
1 f7 + f8 M v1–v8 Lower
2 f9 + f10 O v3–v12 Lower
3 f2 + f6 R v15–v16 Upper
4 f3 + f4 T v9–v18 Upper
5 f1 + f5 U v19–v20 Ceiling + back wall
f11 (Door) single panel Lower

The five pairs + door cover all 11 built faces exactly once. Note f5 is an upper-ring wall: pair 5 is "the ceiling and the wall it hinges to," not two ceiling panels.

The remaining 20 lettered joints are hinged on site during erection (2 hinges each, matching letters). Joint edges are crowded: 2 hinges + an internal LED strip (Step 4) + on joint M also speaker M (Step 5) + an external edge cover (Step 7) all share the same edge — see Open Items.

2.2.2 Erection sequence

Phase 1 · Lower section
pair f7-f8 · pair f9-f10 · door f11

Phase 2 · Upper section
pair f2-f6 · pair f3-f4

Phase 3 · Close the top
pair f1-f5 (ceiling + back wall)

  1. Lower section: stand pair f7-f8, pair f9-f10, and the door f11 on their ground edges (per the landing map in 2.2.3) and hinge the adjacent lower joints (L, N, K — matching letters).
  2. Upper section: lift pair f2-f6 and pair f3-f4 onto the lower ring; hinge every letter that meets (C, D, E, F, G, H, I, J, A, B, S).
  3. Close with pair f1-f5: the last lift places the 5th upper wall (f5) and the ceiling (f1) together; hinge the remaining letters (P, Q, V, X, Y, Z). Closing this pair locks the whole solid rigid.

⚠ Until Phase 2 ties them together, the lower panels lean inward at ~116.57° and are not self-supporting — temporary bracing/props are required (spec TBD, see Open Items). The f1-f5 pair is the heaviest, highest lift; rigging method TBD.

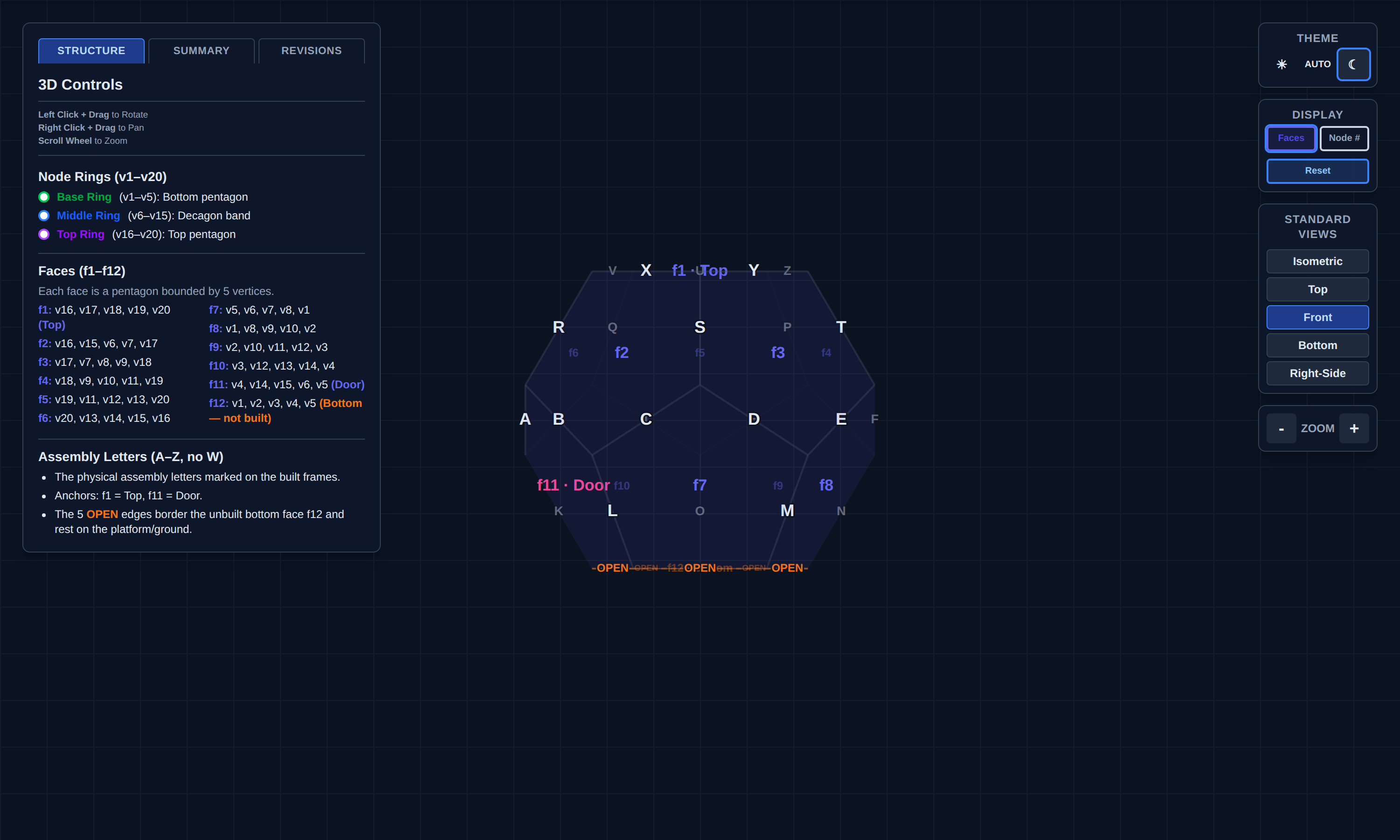

Front view of the lettered frame Front standard view — useful when checking letter positions phase by phase. Snapshot of NaoDec_3D_Structure_Framework_Rev1.0.html.

2.2.3 Base placement & registration

The 5 unlettered ground edges land on the platform as:

Ground edge Belongs to face
v5–v1 f7
v1–v2 f8
v2–v3 f9
v3–v4 f10
v4–v5 f11 (Door)

Cross-References

Safety

Release Gate

Gate Required Result
11 panels built Frame + fabric complete, letters marked, hinge halves fitted per 2.2.1
5 pairs + door pre-built Pair hinges (M, O, R, T, U) fold freely and seat at the dihedral
Base registered Ground edges on the platform marks; v1 corner where planned
All 25 joints hinged 2 hinges per joint, matching letters verified
Door Operable from inside and outside (mechanism per Open Item #1)
Ground edges Hinge-free, seated on the platform

Open Items

  1. Door mechanism — with all four of its lettered edges hinged (A, B, K, L), how does f11 open? Designate a swing edge + lift-off/removable-pin hinges on the other three, or make the whole panel removable. Affects Step 7 (covers on door edges) and egress.
  2. Hinge spec — type, size, load rating, removable-pin or fixed, corrosion finish: TBD. 50 hinges + spares.
  3. Temporary bracing for Phase 1/2 — props, clamps, crew count: TBD.
  4. Site orientation of v1 + platform registration-mark method (2.2.3).
  5. Hardware sharing the joint edges — 2 hinges + internal LED strip + (joint M) speaker + external cover per edge; a per-edge layout that keeps them from colliding is TBD.
  6. Panel construction specifics (2.1) — materials, joinery, fabric, fasteners, dimensions, weight.
  7. Side vs. Ceiling build differences (2.1.1.1) — plus the door as a likely third variant.
  8. Painting/finishing — the paint comparison doc exists but no step schedules painting.
